The administration of a biological hazard
Somebody has to sign the closure notice, and the signature dates the loss.

A harmful algal bloom is a scientific event that arrives as an administrative one. An advisory to draft, a beach to close, a plant to re-rate, a harvest to suspend, and a public that wants an end date. The same signature starts a dated loss on each balance sheet inside the line it draws.
Why this is hard to govern
Four authorities, one bloom, no shared budget line.
In most jurisdictions one event is watched by an environment agency, judged by a public-health laboratory, closed by a fisheries or municipal authority, and absorbed by a water utility answering to none of them. Each has its own trigger, instrument and committee. None owns the water.
That division is how competence is organized, and it mostly works for chemical spills and sewage failures, where the source is a point and the responsible party has a name.
A bloom is diffuse, biological and weather-driven, and its cause was spread across ten thousand hectares of catchment over thirty years. The instrument that would fix it sits in an agriculture ministry. The one that answers the phone this week sits elsewhere.
The practical question is which functions are covered, which assumed, and which have no owner at all.
Program anatomy
The functions a bloom program has to cover.
Names and ministries differ by country. The functions do not.
| Function | Where it usually sits | What it produces | How fast it acts |
|---|---|---|---|
| Surveillance | Environment agency, often with a university or institute contract | Cell counts, chlorophyll imagery, a sample archive | Days to weeks; faster inside a declared season |
| Toxin analysis | Public-health or food-safety laboratory | Toxin concentrations, reported by matrix | Days, and the queue lengthens exactly when it matters |
| Advisory | Health directorate | A public notice carrying a named signatory | Hours, once a defensible number exists |
| Closure | Fisheries authority, municipality or port | Suspension of harvest, bathing or navigation | Hours to days |
| Drinking-water response | The utility, under a regulator's standing conditions | Treatment change, blending, or an alternative source | Immediate, and expensive |
| Public communication | Whoever answers the telephone first | The version of events the public will remember | Immediate, whether you are ready or not |
| Nutrient reduction | Agriculture, planning and wastewater regulation | Catchment load targets, permit conditions, subsidy rules | A decade or more, if it holds through elections |
| In-water intervention | Usually unassigned | Nothing, in most programs we have read | Not scheduled |
The ledger
What a documented bloom has cost, when somebody bothered to count.
Treasury officials ask for a number and receive an adjective. Few events have one in a public agency record.
Most are United States figures because NOAA publishes them as a series. Comparable series for the Gulf, the Mediterranean and East Asia are thinner, and a missing figure is no missing loss.
| Event | Documented impact | Source |
|---|---|---|
| Maryland, 1998 | $81 million in lost seafood sales after a Pfiesteria event | NOAA Fisheries |
| Maine, 2005 | $7.2 million in direct harvester losses; $49.46 million in total lost income | NOAA Fisheries |
| Texas, 2011 | $10.3 million drop in oyster landings | NOAA Fisheries |
| Indian River Lagoon, 2011 | $235–470 million potential loss from seagrass damage — a modeled range, published as an estimate | NOAA Fisheries |

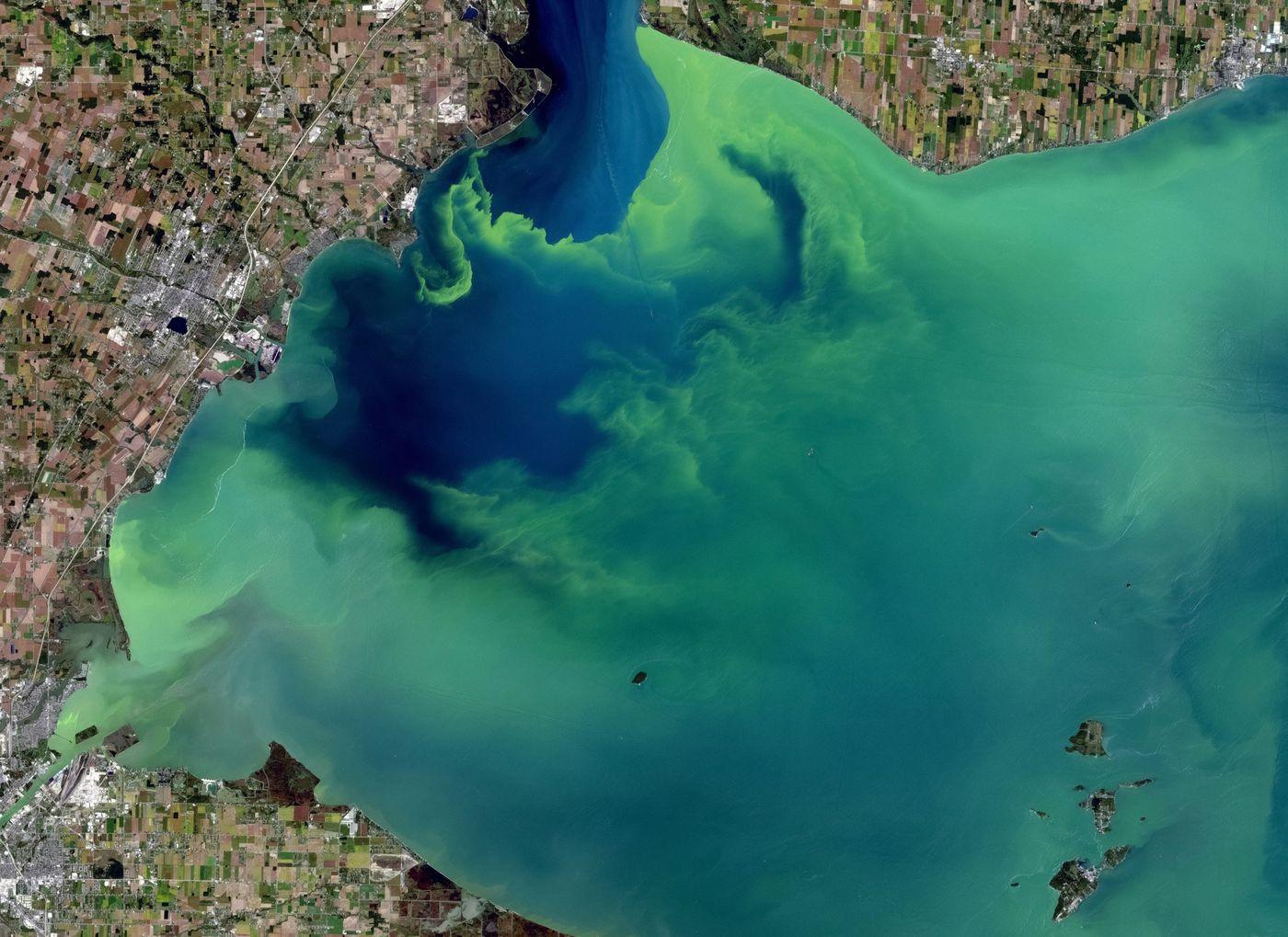

| Toledo, Ohio, 2014 | Roughly 500,000 residents advised not to drink tap water; $10.05 million in lost shoreline property-value services | NOAA Fisheries |
| United States West Coast, 2015 | $97.5 million in lost Dungeness crab landings, plus about $40 million in tourism spending lost to razor clam closures | NOAA Fisheries |
| Worldwide, 2000–2020 | Fish-killing blooms associated with more than US$8 billion in losses across the global event database | Reviews in Aquaculture, 2024 |
A University of Central Florida study put the 2018 Florida red tide season at $2.7 billion across the state, split roughly between the south-west and south-east coasts. The figure comes through secondary reporting of the published paper, the paper itself unread, so it is indicative and belongs in no submission until the original is checked.
What the signature starts
A closure is a health decision upstream and a dated event everywhere downstream of it.
The notice carries an hour, a boundary and a reason. Those three are what the rest of the coast has to count with.
Inside the line, trading stops at a known moment. A harvest is suspended. A plant re-rates. A frontage empties. Each of those is an interruption whose start time was written by somebody else, which is unusual. Most interruptions begin with a failure the operator watched approach. This one begins with a signature.
The boundary does the second piece of work. What sits inside it is affected by decision. What sits a hundred meters outside is affected by proximity and has no notice to point at. Where the boundary is drawn is a public health judgment first. It is also the difference between a business holding a document and a business holding an argument.
The reason does the third. An advisory naming a parameter and an action level files the event under something recognizable: an algal bloom, oxygen below a stated level, harm to a natural resource. Where a jurisdiction attaches no liability regime to water condition, harm to plant and stock and the trading days lost behind it are the two headings the whole event has to fit into, and the notice is what dates both of them.
Then the lift. The date a notice is withdrawn closes the count, and a notice standing after the water has cleared keeps a loss running for reasons of process. Clearance criteria fixed in advance, with the sampling that satisfies them named, are what let a notice come off on the day the water clears.
None of this argues for closing less often. The decision belongs where the statute put it, and a directorate that closes early and explains why is doing its job. It argues for a notice carrying its hour, its boundary, its reason and its clearance criteria on the face of it, because four lines of drafting hand everybody downstream a document instead of leaving them to assemble one from press reports.
Four lines a notice can carry at no extra cost
- The hour it takes effect, not the day.
- The boundary as coordinates or a named stretch, so that what is outside is plainly outside.
- The parameter and the action level that triggered it, with the laboratory named.
- The criteria for lifting it, written before the event they will be applied to.
The directorate gains a cleaner audit trail. Everybody downstream gains a dated document. It is the same afternoon's work either way.
The uncomfortable evidence
The Baltic did the hard thing, and the dead water stayed.
Two decades of load reduction, and a larger hypoxic area.
Nine countries have run the HELCOM Baltic Sea Action Plan for two decades: agricultural regulation, wastewater investment, national input ceilings, multilateral negotiation. By environmental-policy standards it is the most serious attempt anyone has made.
HELCOM's own indicator, published in October 2025, records real cuts in both nutrients. The Baltic Proper and the Gulf of Finland — the two sub-basins that most needed them — still fail their maximum allowable input for both.
Meanwhile the hypoxic area grew. Sediment holds phosphorus and gives it back under low oxygen. Stratification is stronger in a warming sea. The system's memory runs in decades.
Catchment work does not fail. It is slow, and the fisheries, beaches, intakes and public confidence spent in the meantime are also public assets. Alarivean works in that interval.
So the line is a standing subscription, funded from the recurrent budget the way a treatment works is. Nutrient, heat and stratification accumulate whether or not a directorate has declared anything. Held down continuously, none reaches the state that produces a closure, a do-not-drink notice and an emergency procurement in the same fortnight. Bought after the event has formed, the same capability comes at emergency rates, from a contingency reserve, with mobilization on top.
Before the first meeting
Four things a drafter should hold the intervention line to.
Four reasonable reservations, better settled in the instrument than in a select committee in year two.
- The catchment target stays exactly where it was In-water work sits beside nutrient reduction on the schedule, never in place of it. A ministry that presents the two as interchangeable will be held to that in a decade.
- Your monitoring obligation goes up There is now a treatment to verify as well as a bloom to track.
- Your regulator stays your regulator Permitting, discharge conditions and the closure decision remain exactly where the statute put them. The work is delivered inside that framework and never alongside it.
- No open-water result has been published Not for this class of treatment, from anybody. What exists is pond-scale and tank-scale validation and a Florida trial permit. A jurisdiction gets its own number from a calibration phase on a bounded area of its water, against viability parameters agreed in writing first.
Evidence and validation record: seabreather.com.
The row with no owner
Assign the intervention. Then assign the people who watch it.
Give in-water intervention an owner and a second gap opens the same afternoon: oversight. Close the first alone and the strategy will not survive its first bad night.
Every other function in a bloom program has an institution with something to lose behind it. The laboratory is accredited. The advisory carries a signature and a professional register. The utility answers to an economic regulator that can fine it. Built over decades, that is what makes their outputs usable at an inquiry.
An intervention supplier holds none of that. If this goes wrong, who finds out, how fast, and are they somebody the directorate is not paying?
Alarivean builds the answer in at design: local scientific expertise engaged continuously, with access to every water-quality feed the operator works from and room for whatever those institutions bring, and human and environmental safety ranked first in the risk controls. It belongs in the schedule.
What it changes in the document
The intervention line becomes a function shaped like the rest of the program: an actor, an overseer, a data flow, and a defined route by which a problem becomes somebody else's knowledge.
In drafting terms, one clause naming the oversight institution and its access, beside the clause naming the supplier. Not an annex.
What it does not change
Your regulatory position, in any respect. Oversight substitutes for no permit, discharge condition or closure decision.
Nor does it settle whether the technology works. It produces an unbroken record a body other than the supplier can stand behind at an inquiry.
Related reading in this network
Immediate, Significant, Scaled
Send us the program document.
The water body, the season, the monitoring you run and the decision you cannot yet make. Back comes a staged assessment of what in-water work would change there, where it would leave the water as it is, and a named program lead, in writing, before anything is contracted.
The instrument carries a subscription to an ongoing program, delivered by a licensed service operator, held to conditions your regulator agreed first, and running through the quiet months too. It ends on two grounds. Performance outside the agreed spec ends it, and so does a client who has served the minimum period and is simply not satisfied — a shorter leash than most infrastructure contracts allow.
